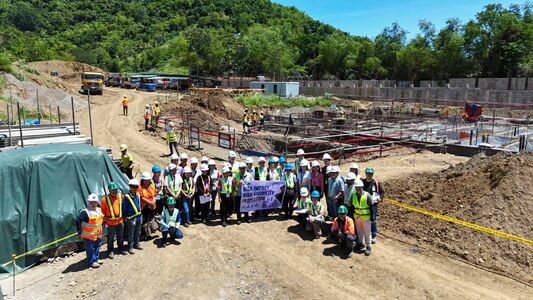

There are currently 55 temples that are under construction. Once each temple is completed, it will be opened to the public for an open house before being dedicated for ordinance work.

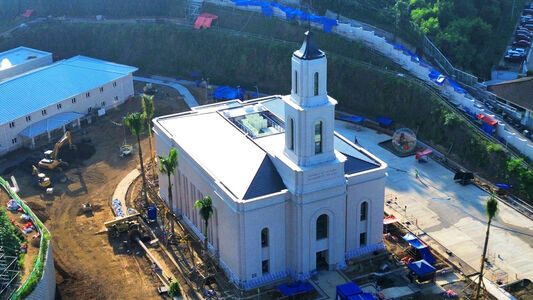

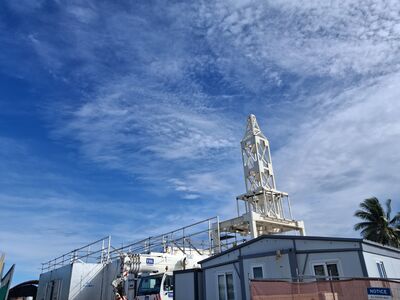

Preparing for dedication

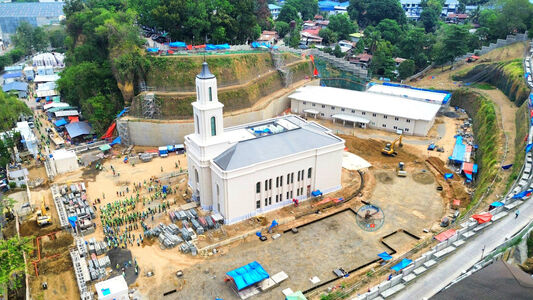

Preparing for public open house beginning 17 April 2025
Preparing for public open house beginning 1 May 2025
Preparing for public open house beginning 10 May 2025

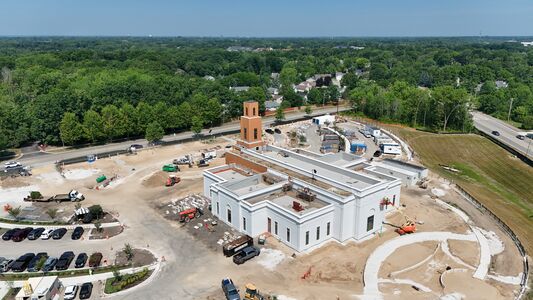

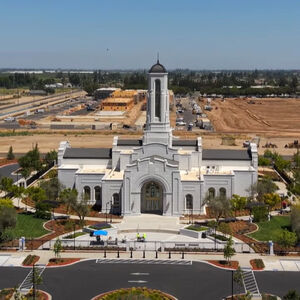

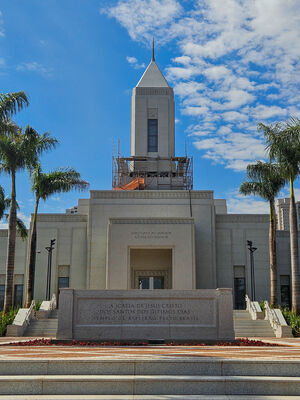

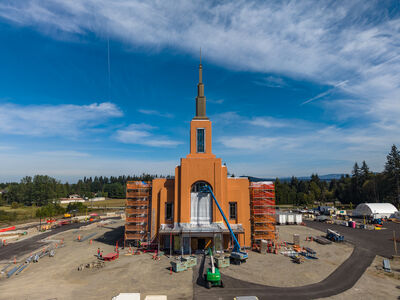

Major construction completed; applying finishing touches; temple president and matron called
Major construction completed; applying finishing touches; temple president and matron called
Major construction completed; applying finishing touches; temple president and matron called

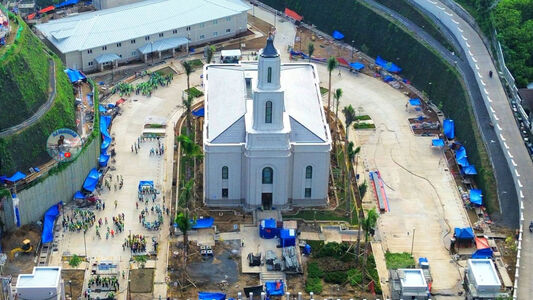

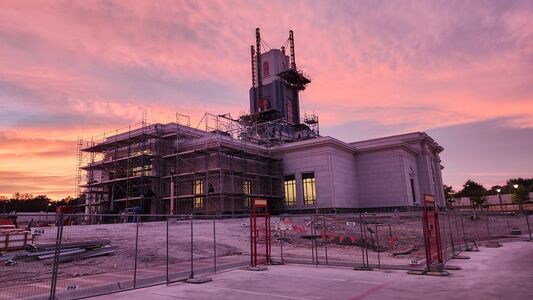

Major construction completed; applying finishing touches; temple president and matron called

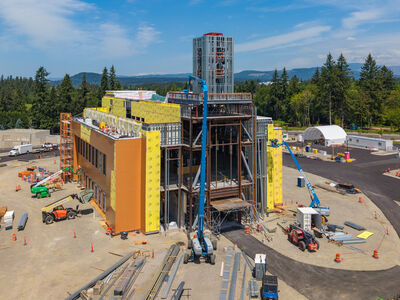

Major construction nearing completion; furniture deliveries being made; temple president and matron called
Major construction nearing completion; interior finish work underway; temple president and matron called

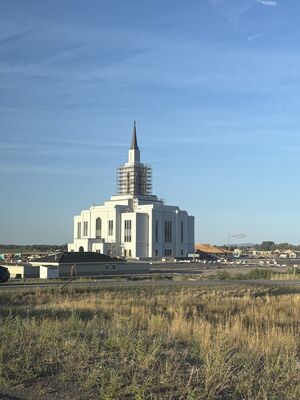

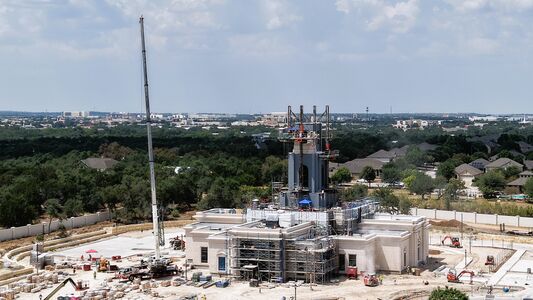

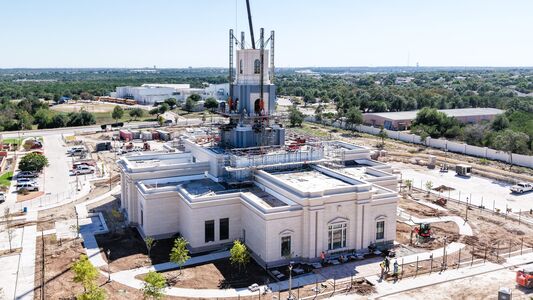

Major construction nearing completion; architectural lighting installed

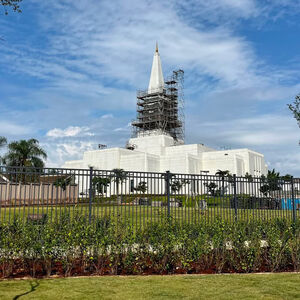

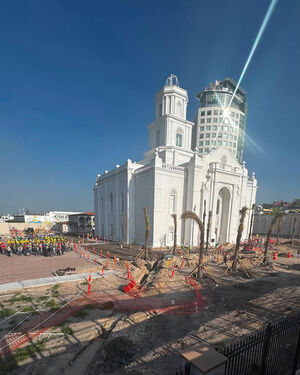

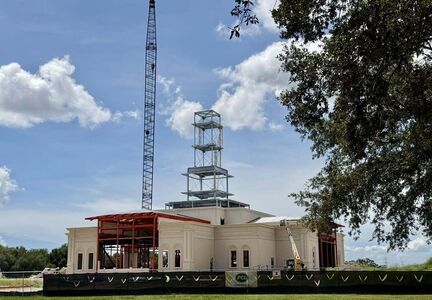

Exterior lighting operational; landscaping and interior work well underway; temple president and matron called
Exterior lighting operational; interior work and landscaping progressing

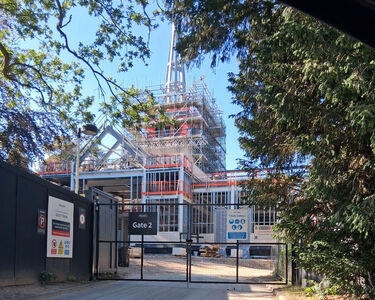

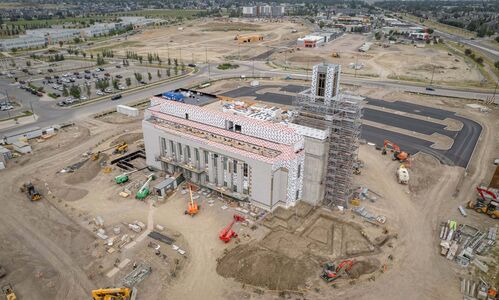

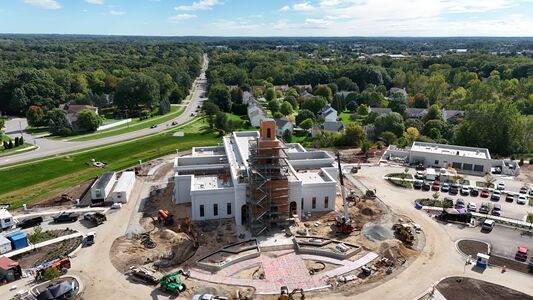

Stone cladding and hardscaping well underway; grass sod laid; installing art glass; interior finish work and landscaping progressing; temple president and matron called

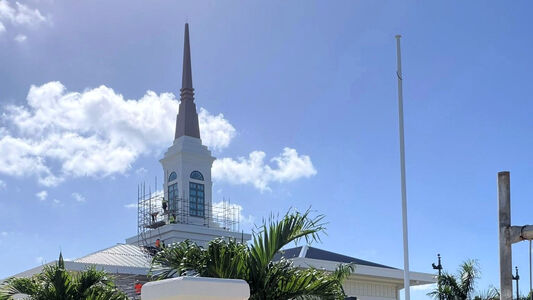

Installing art glass; landscaping and interior work progressing

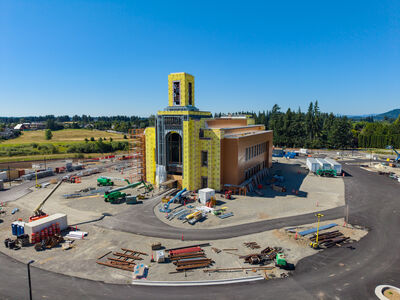

Installing stained-glass windows; stone cladding underway

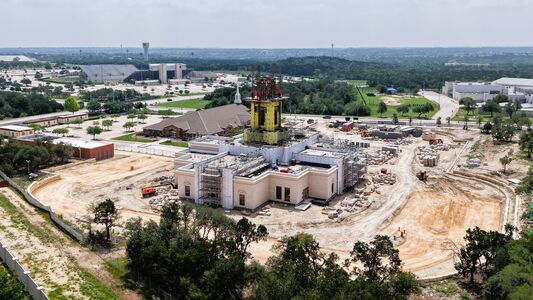

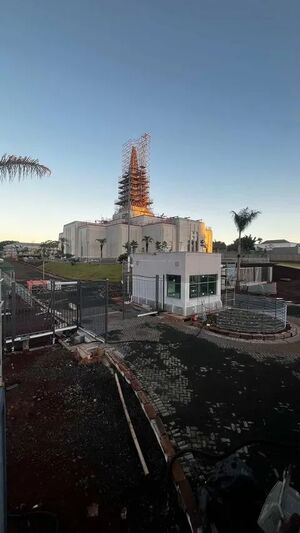

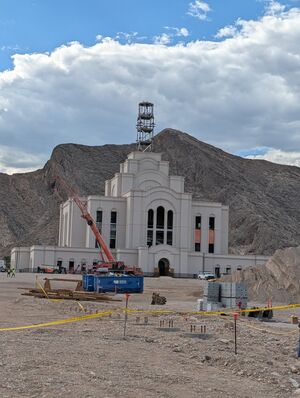

Lighting installed inside the steeple; entrance door frame installed; installing the hardscape for the grounds; interior work progressing

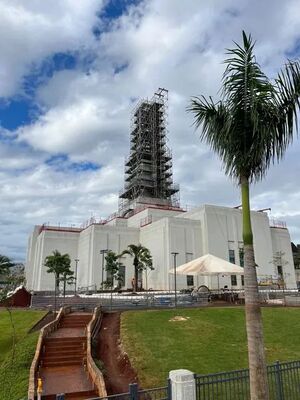

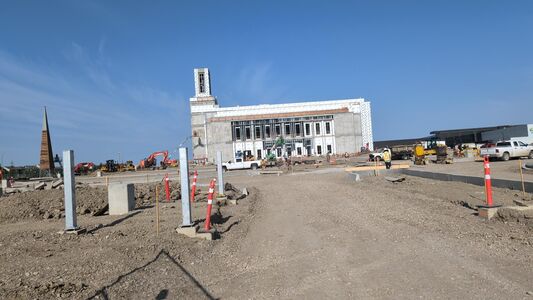

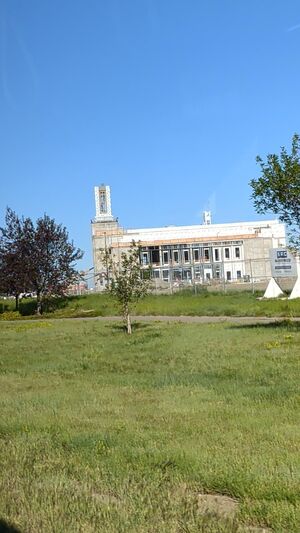

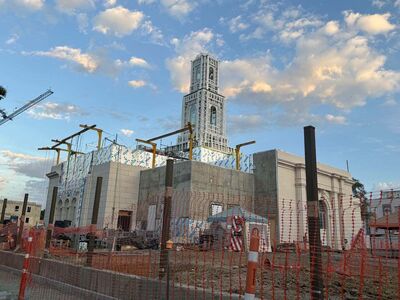

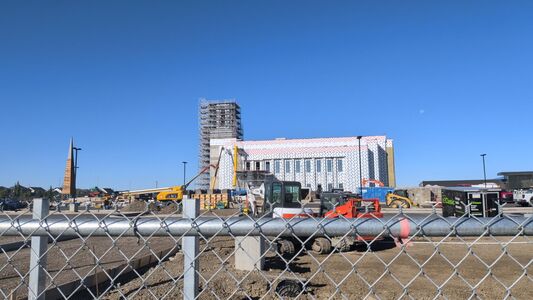

Cupola installed; stone cladding nearing completion; landscaping and interior work progressing
Exterior cladding underway; landscaping and interior work progressing

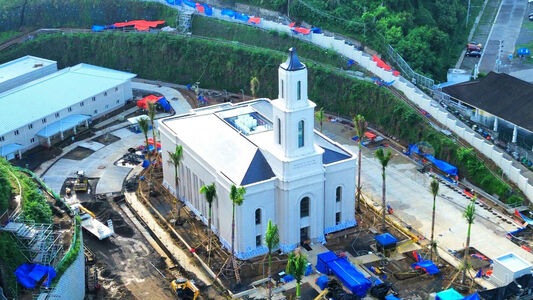

Exterior cladding completed; installing stained-glass windows
Planting vegetation on the grounds; installing ornamental fence; cladding the exterior walls; interior work progressing
Installing art glass windows and exterior moldings; landscaping and interior work progressing

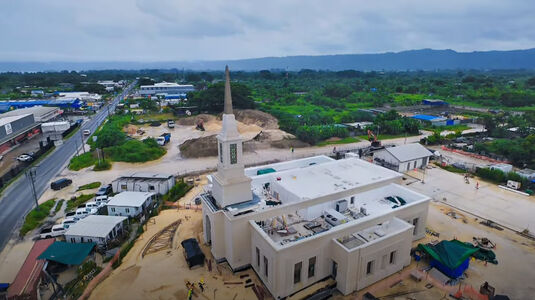

Roofing completed; scaffolding removed from spire; landscaping and interior work progressing
Exterior cladding underway; interior work progressing

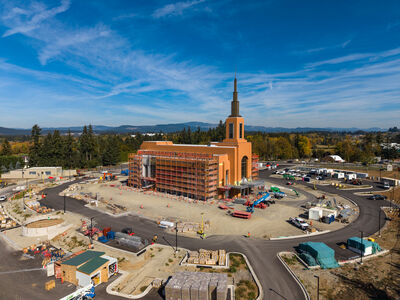

Exterior cladding and sheathing underway; landscaping and interior work progressing
Installing stained glass; finishing the exterior walls
Installing art glass; stone cladding underway; interior work progressing
Exterior cladding and hardscaping underway
Exterior cladding and sheathing underway; hardscape being installed; meetinghouse roofed
Stone cladding underway; sheathing and weatherproofing the exterior
Steeple frame installed; stone cladding started
Exterior cladding underway

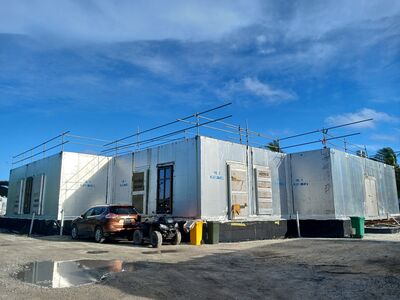

Prefabricated modules installed; installing windows
Modules and glass windows installed; upper structures framed

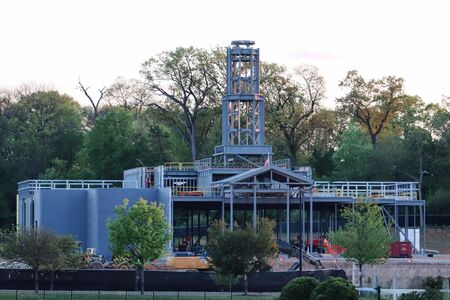

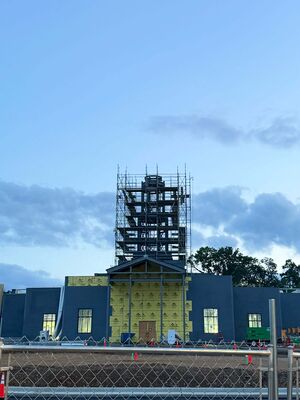

Framing the temple steeple; new missionary couple arrived

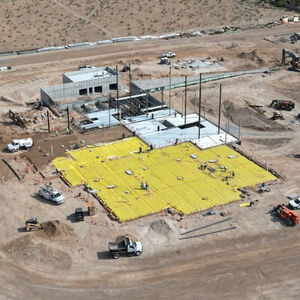

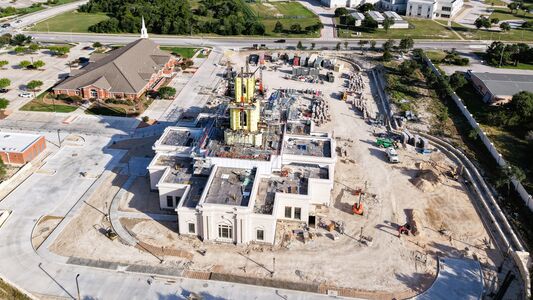

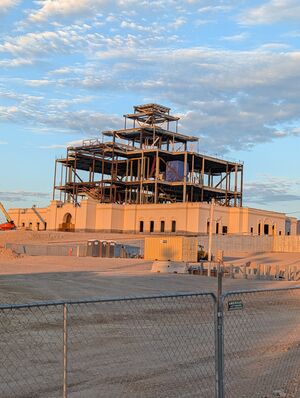

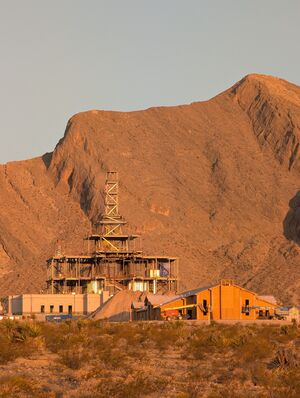

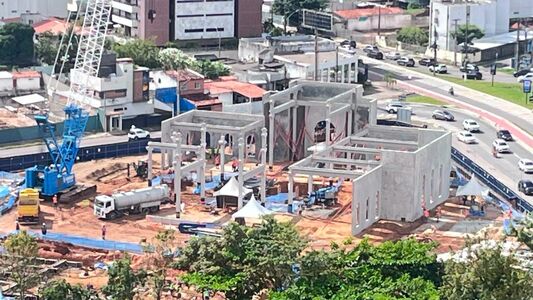

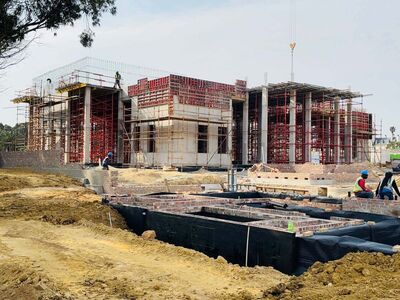

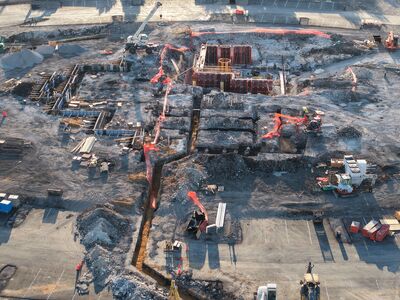

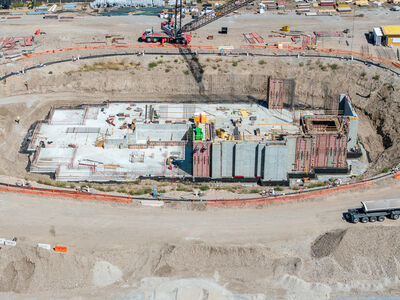

Building the concrete structural frame

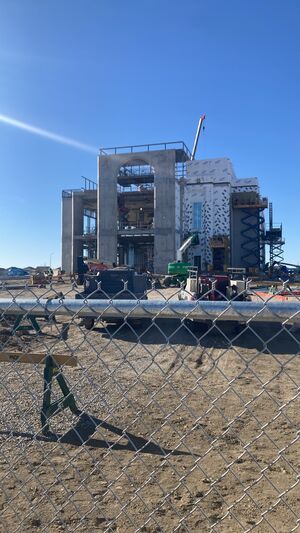

Building the reinforced concrete structural walls

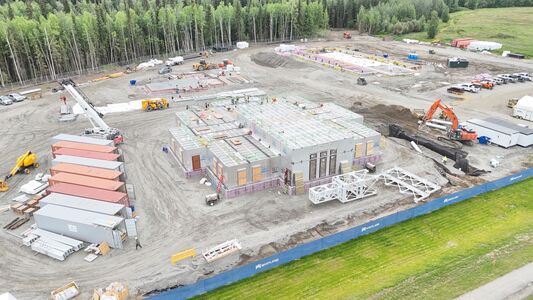

Building structural walls for steeple pedestal; roofs added to ancillary buildings
Concrete exterior walls installed; building the roof structures

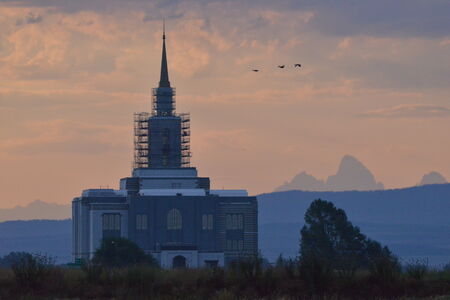

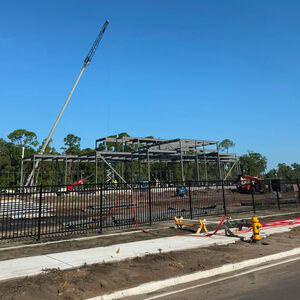

Sheathing the exterior; steeple frame in place; windows installed

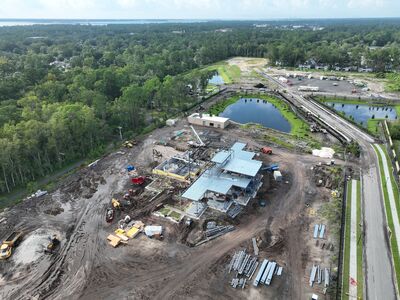

Framing upper structures of temple; floor slab poured for distribution center
Construction temporarily delayed; concrete structural frames in place for temple and ancillary building; window openings shuttered

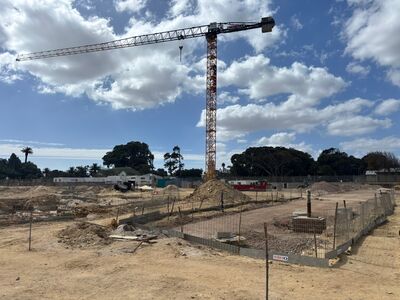

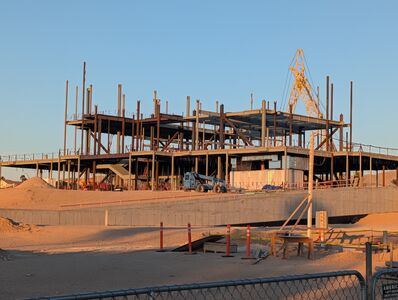

Erecting exterior walls
Erecting the reinforced concrete structural walls

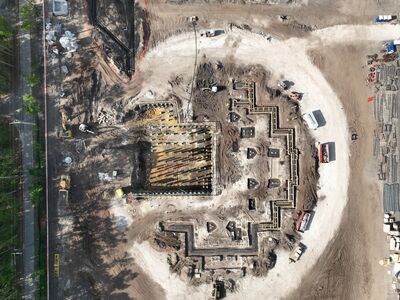

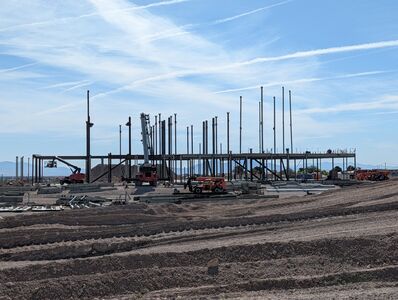

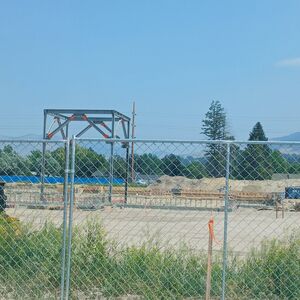

Structural framing underway
Framing the superstructure

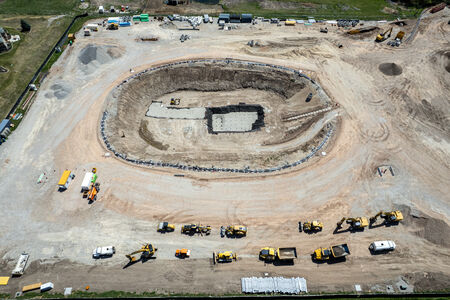

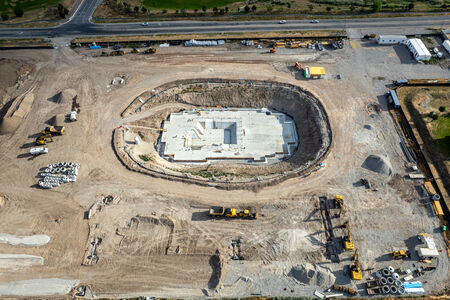

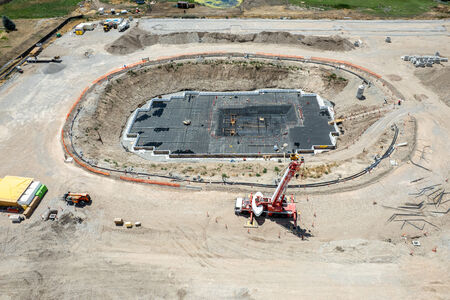

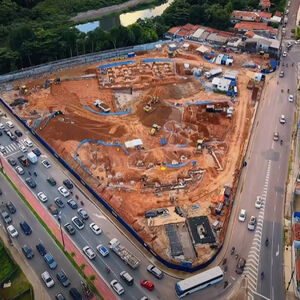

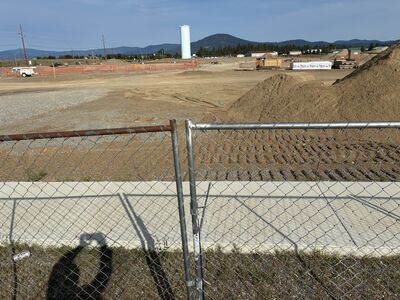

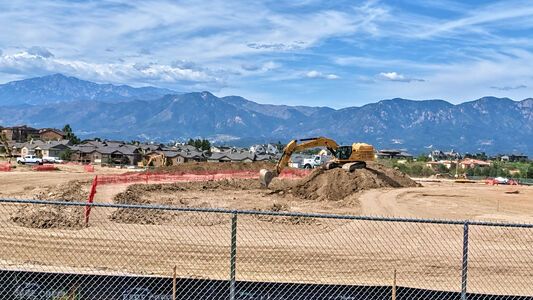

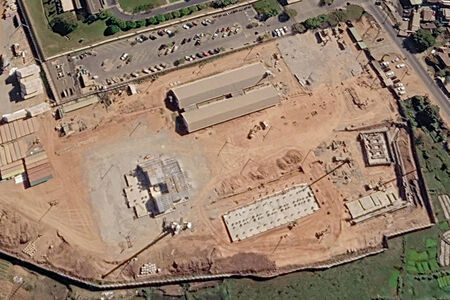

Foundation work and underground utilities underway

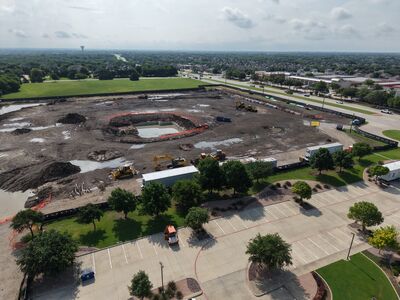

Installing foundation; constructing ancillary building; preparing ground for parking lot

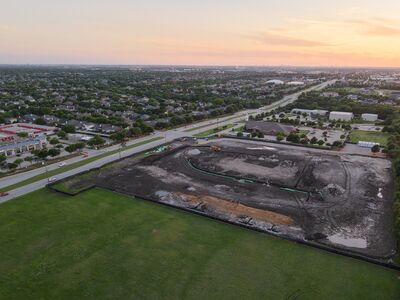

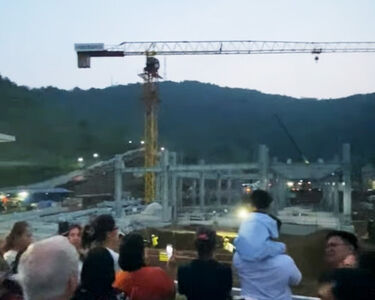

Groundbreaking ceremony held on 2 November 2024; full-scale construction pending
Building tiered retaining wall and temple foundation
Groundbreaking ceremony held on 8 October 2022; full-scale construction pending
Groundbreaking ceremony held on 18 January 2025; full-scale construction pending
Groundbreaking ceremony held on 1 March 2025; full-scale construction pending
Groundbreaking ceremony held on 15 March 2025; full-scale construction pending
Groundbreaking ceremony held on 22 March 2025; full-scale construction pending
